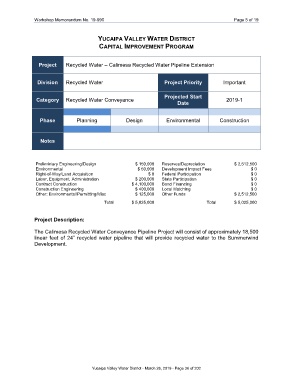

Workshop Memorandum No. 19-090 Page 5 of 19
YUCAIPA VALLEY WATER DISTRICT
CAPITAL IMPROVEMENT PROGRAM
Project Recycled Water – Calimesa Recycled Water Pipeline Extension
Division Recycled Water Project Priority Important
Projected Start
Category Recycled Water Conveyance 2019-1
Date
Phase Planning Design Environmental Construction
Notes
COST BY TYPE FUNDING SOURCE
Preliminiary Engineering/Design $ 150,000 Reserves/Depreciation $ 2,512,500
Environmental $ 50,000 Development Impact Fees $ 0
Right-of-Way/Land Acquisition $ 0 Federal Participation $ 0
Labor, Equipment, Administration $ 200,000 State Participation $ 0
Contract Construction $ 4,100,000 Bond Financing $ 0
Construction Engineering $ 400,000 Local Matching $ 0
Other: Environmental/Permitting/Misc $ 125,000 Other Funds $ 2,512,500
Total $ 5,025,000 Total $ 5,025,000
Project Description:
The Calimesa Recycled Water Conveyance Pipeline Project will consist of approximately 18,500
linear feet of 24” recycled water pipeline that will provide recycled water to the Summerwind
Development.
